Construction companies use AI-powered document processing to automatically extract key contract information, including project dates, payment terms, contract values, insurance requirements, and liability clauses. Instead of manually reviewing lengthy PDFs, teams can turn contracts into searchable, structured records in minutes and receive alerts for important deadlines.
Key Takeaways:
- Extract key contract data automatically, including dates, values, payment terms, and liability clauses.
- Reduce review time from hours to minutes by converting contracts into structured records.
- Use Parseur to automate contract processing, track critical deadlines, and flag high-risk terms for review.
Construction companies extract data from contracts using AI-powered document parsing that automatically identifies key information such as project scope, start and completion dates, payment schedules, liability clauses, and change order procedures from PDF contracts received by email. According to Thomson Reuters, AI contract analysis tools can surface key contract terms and obligations in minutes rather than hours, helping legal and operations teams reduce manual review work and improve compliance visibility.
The workflow is straightforward: a contract arrives by email, AI extracts the critical fields, and the data is sent to a contract management system such as Airtable, Notion, SharePoint, or another business platform. The system can then create reminders for important deadlines, track payment milestones, and flag unusual terms for legal or management review.
By automatically converting contracts into structured data, construction teams gain a centralised view of key obligations, deadlines, and financial terms without having to manually review every page. This makes it easier to track completion dates, monitor payment schedules, manage compliance requirements, and quickly locate contract information when questions arise during a project.
According to the Contract Management Survey by Contractify, more than 60% of organisations reported problems managing contracts, including slow processes, information loss, untraceable contracts, and missed responsibilities. Automating contract extraction helps centralise critical data, improve visibility, and reduce the risk of overlooked obligations.
This approach eliminates the need to manually review and highlight lengthy contracts, a process that often takes 1 to 2 hours per document. It also helps prevent missed completion dates, overlooked payment obligations, and compliance risks caused by contracts being buried in email inboxes.
Instead of searching through dozens of pages, construction teams can access key contract terms instantly through a searchable, structured database.
Contract Data: What Construction Companies Need To Track
Construction contracts contain far more than project descriptions and pricing. They include critical dates, financial obligations, liability clauses, and compliance requirements that construction teams must monitor throughout the project lifecycle.
Project Details
- Project name and description
- Site address
- Contract value
- Project start date
- Substantial completion date
- Completion date
Financial Terms
- Payment schedule (monthly or milestone-based)
- Retainage percentage (typically 5 to 10%)
- Change order procedures
- Late payment penalties
- Liquidated damages
Obligations and Liability
- Insurance requirements
- Warranty periods
- Defect liability periods
- Indemnification clauses
- Limitation of liability terms
Administrative Requirements
- Notice procedures
- Dispute resolution clauses
- Governing law
- Force majeure provisions
The challenge is that this information is often spread across dozens of pages. A typical construction contract can range from 20 to 80 pages, and manually reviewing a single agreement can take 1 to 2 hours. Finding specific clauses usually means searching for keywords or reviewing pages one by one.
When managing 20 to 30 active contracts, tracking completion dates, payment milestones, retainage terms, and notice deadlines quickly turns into spreadsheet chaos. Missing a substantial completion date can trigger liquidated damages. Missing a payment milestone can delay cash flow. Missing a notice requirement can create legal risk.
What construction companies need is a way to automatically extract key contract data into a searchable database that tracks deadlines, surfaces important terms, and flags high-risk clauses before they become costly problems.

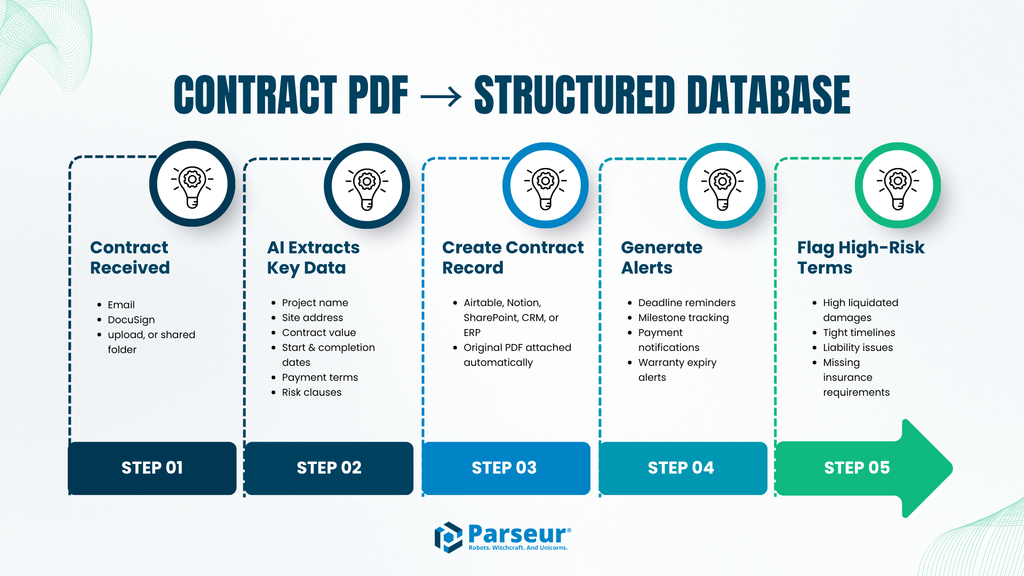

The Automated Process: Contract PDF to Structured Database

Instead of manually reviewing lengthy contracts, construction companies can automate contract extraction using AI. The workflow takes just a few minutes and transforms a PDF into structured, searchable data.
Step 1: Contract Arrives
Contracts typically arrive through email attachments, DocuSign or e-signature platforms, shared folders, or direct uploads. The contract is automatically sent to Parseur for processing.
Step 2: AI Extracts Key Contract Data (2 to 3 Minutes)
Parseur analyses the entire contract and extracts critical information, such as project name, site address, contract value, start and completion dates, payment schedule, retainage percentage, liquidated damages, insurance requirements, and warranty and defect liability periods.
For example, the AI may identify a contract value of £2.45M, a completion date of 30 November 2027, a retainage of 5%, and liquidated damages of £1,000 per day. No manual highlighting or clause searching required.
Step 3: Create a Contract Record (30 Seconds)
Using Zapier or Make, the extracted data is sent to Airtable, Notion, SharePoint, or another contract management system. The automation creates a new contract record, populates all extracted fields, attaches the original PDF, and sets the status to "Under Review."
Teams now have a searchable contract database instead of folders full of PDFs.
Step 4: Generate Automatic Alerts
Important dates are automatically tracked and monitored. Examples include project start date reminders, completion deadline alerts, warranty expiration notifications, and payment milestone reminders. Teams can also receive notifications through email, Slack, or Microsoft Teams when new contracts are processed.
Step 5: Flag High-Risk Terms
AI can identify contract terms that may require legal or management review, including high liquidated damages, aggressive completion deadlines, non-standard liability clauses, missing insurance requirements, and unusual payment conditions. This helps teams focus their review on potential risks instead of reading every page manually.
Total processing time is approximately 3 to 4 minutes, compared to 1 to 2 hours of manual contract review.
Set Up Contract Extraction In 30 Minutes
You do not need a dedicated contract management platform to automate contract review. With Parseur, Airtable, and Zapier or Make, you can build a contract extraction workflow in about 30 minutes.
Before starting, you will need a Parseur account, Airtable, Notion, or SharePoint, a Zapier or Make account, and 2 to 3 sample construction contracts.
Step 1: Configure Parseur
Create a Parseur mailbox and upload a few recent construction contracts from different clients or project types. Parseur's AI automatically identifies common contract fields, including project name, client name, site address, contract value, start and completion dates, payment terms, retainage percentage, and insurance requirements.
You can also create custom fields for information specific to your business, such as subcontractor obligations, change order clauses, or warranty periods. Once the fields are configured, future contracts can be processed automatically.
Step 2: Connect Parseur to Airtable
Create an Airtable base called "Active Contracts" and add columns for each key field:
| Airtable Column | Field Type |
|---|---|
| Project Name | Text |
| Client | Text |
| Site Address | Address |
| Contract Value | Price |
| Start Date | Date |
| Completion Date | Date |
| Payment Terms | Text |
| Retainage % | Number |
| Liquidated Damages | Text |
| Insurance Requirements | Long Text |
| Status | Choice List |
| Attachment |
Next, create a Zapier or Make workflow with the trigger set to "New document processed in Parseur" and the action set to "Create a record in Airtable." Map each extracted field to the corresponding Airtable column and attach the original contract PDF to the record.
This automatically creates a searchable contract database.
Step 3: Set Up Date Alerts
Connect Airtable to Google Calendar, Outlook, or your preferred scheduling platform. When contract dates are extracted, automation can create project start reminders, completion deadline alerts, payment milestone notifications, and warranty expiration reminders.
For example: Start Date generates a calendar event, Completion Date generates a calendar event plus a 30-day advance reminder, and Warranty Expiry generates a future reminder event. This ensures that critical contract deadlines never remain hidden in a PDF.
Step 4: Flag High-Risk Terms Automatically
Use Zapier or Make conditions to identify contracts that require additional review. Examples:
For high liquidated damages: if the liquidated damages exceed £500 per day, tag the contract as High Risk and notify the Legal Team.
For aggressive project timelines: if the contract value is over £1M and the completion timeline is under 12 months, tag it as Tight Timeline and notify the Project Manager.
You can create similar rules for missing insurance requirements, unusual payment terms, large retainage percentages, and non-standard liability clauses.
The result is a contract workflow that automatically extracts key terms, tracks deadlines, and highlights potential risks, without requiring teams to manually review every page.
Industry Data On Contract Processing Time
Construction contracts are becoming larger, more complex, and more difficult to manage manually. For many contractors, project managers, and operations teams, contract review creates a significant administrative burden long before work begins on-site.
Research from Contracts Connected found that manual contract administration can consume 20 to 25 hours per week per active construction project, driven by document reviews, compliance tracking, payment administration, and change order management. AI-powered contract systems reduced that workload to an estimated 5 to 8 hours per week while improving documentation accuracy.
The challenge grows as contract volume increases. According to Newforma's AECO Project and Information Management Survey, 77% of architecture, engineering, construction, and owner firms report missing project deadlines due to poor project information management, including difficulties locating, tracking, and managing critical project documents. This highlights how contract reviews, milestone tracking, and document workflows can become major operational bottlenecks when handled manually.
Key information is often buried throughout the document, including completion deadlines, payment milestones, retainage terms, insurance requirements, change order procedures, and liability clauses. Missing even one critical date can lead to costly downstream consequences.
According to KPMG's Global Construction Survey, 75% of construction executives say they are as risk-averse or more risk-averse than they were a year ago, reflecting growing concerns around project complexity, regulatory requirements, supply chain pressures, and contract risk. These challenges have increased the need for stronger contract management, deadline tracking, and risk monitoring throughout the project lifecycle.
Instead of manually reading and highlighting every contract, AI-powered extraction tools can automatically identify key dates, payment terms, obligations, and risk clauses. Contract data is then stored in a searchable database, where teams can track deadlines, generate alerts, and review high-risk provisions more quickly.
For companies processing dozens of contracts annually, reducing contract review from hours to minutes can save significant administrative time while improving visibility, compliance, and project oversight.
Last updated on
